Addition to a Residential Building |
Under the Building Code Act, a building permit is required for the construction of a new building, an addition, or alteration of any building or structure with a building area of over 10 square meters (approximately 108 square feet). Here are examples of additions:
- Sunrooms
- Solariums
- Attached Garages
- Porches
- One and two-storey additions
Document Checklist
- Completed and signed Building Permit Application Form;
- One set of construction plans and specifications;
- Detailed site plan;
- Approved water and sewer allocation form, if the addition is serviced by Public Utilities and an additional dwelling unit is being proposed;
- Completed Mechanical Ventilation Summary sheet;
- Septic permit from South Nation Conservation for a private sewage system if there are any additional bedrooms being added or if any plumbing is being added;
- South Nation Conservation Approval if proposed construction occurs near a water course.
- Septic permit from South Nation Conservation for a private sewage system (if applicable).
Application Process
- Email or call the Building or Zoning Departments.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall. If any plumbing is being added to the building and you are serviced by a private septic system approval from South Nation Conservation is also required.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, construction can begin according to revised plans.
- Call to book your inspections. Your project must be inspected at different stages. These are explained on your building permit.
Permit Fees Fees are subject to change. Building permit fees for an addition to a residential building are $375 for 500 square feet plus $0.70 per square feet after the first 500 square feet. A refundable fee is based on the value of the project:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $99,999 = $500 refundable fee
- Construction value between $100,000 - $299,999 = $1000 refundable fee
Inspections
Inspections for an addition to a residential building
Inspection |
When the Inspection is Required |
Service Inspection |
Once service lines are installed in the trench and before covering the municipal service connections with any stone or material (if applicable). |
Footing Inspection |
Before you pour the footings. You must provide a copy of the soil test from your geotechnical engineer before this inspection, you can email your report to the Building Department. |
Underground Plumbing Inspection |
Before covering the underground plumbing with any material. |
Backfill Inspection |
Before backfilling the foundation, once the dampproofing, weeping tile and stone coverage are installed |
Framing Inspection |
Before insulation, you must have your plumbing, electrical, HVAC completed before this inspection. All Electrical work must be done through a permit from the Electrical Safety Authority. |
Above Ground Plumbing Inspection |
Before insulation, an air or water test must be on for this inspection. |
Insulation Inspection |
Before drywalling, insulation and vapour barrier must be installed. |
Fire Resistance Rating Inspection |
Only applies in some cases and will be noted on your permit. |
Final Inspection |
When all interior and exterior work is complete, and your building permit file can be closed. |
|
Decks |
- Regardless of the deck's walking surface area, if the deck is adjacent to or attached to the house and its walking surface is more than 600 mm (24 in.) above the adjacent grade, a permit is required.
- Regardless of the deck's walking surface area, if the deck is providing principal access to a building, a permit is required.
- If the deck is independent from the house (not attached to the house or any other structure attached to the house) and its walking surface is less than 600 millimeters (24 inches) above the adjacent grade, a permit is not required.
The Ontario Building Code outlines the minimum requirements for various elements, such as joist size, beam size, foundation requirements, guard requirements.
Document Checklist
- Completed and signed Building Permit Application Form;
- One set of deck construction plans and specifications;

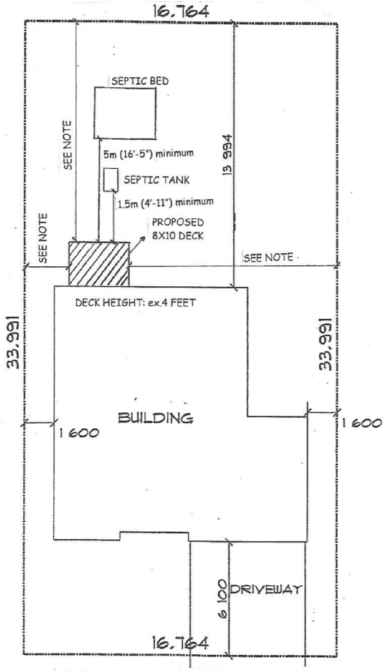

- A detailed site plan;
- South Nation Conservation Authority Approval, if your proposed project is near a water course;
- Engineering approval for techno metal post foundation systems or similar.
Construction plans for a deck must be detailed enough that someone else could take them and build the deck without consulting with you. They can be done by a homeowner as long as all of the required information is on the plans. Deck plans must include information such as: what is the foundation system, size and spacing of foundation system, size and spacing of framing members, stairs, railings, guards, deck height, deck size etc. Some homeowners have used deck designer programs from retail stores or online programs and we can accept those plans for application submissions as well.
When Can I Use Deck Blocks? |
Deck blocks are permitted to be used if the deck will not be attached to the house and when the underside of Joist is less than 24” above grade. The maximum spacing of deck blocks is suggested to be a maximum of 6’ unless otherwise specified by manufacturer. |
What Size of Joists and Beams Do I Need? |
If joists are spaced at 12 inches with bridging:
- Wood Size 2 x 6 = Maximum Span of 10 feet, 4 inches
- Wood Size 2 x 8 = Maximum Span of 12 feet, 5 inches
- Wood Size 2 x 10 = Maximum Span of 14 feet, 6 inches
- Wood Size 2 x 12 = Maximum Span of 16 feet, four inches
If joists are spaced at 16 inches with bridging:
- Wood Size 2 x 6 = Maximum Span of 9 feet, 4 inches
- Wood Size 2 x 8 = Maximum Span of 11 feet, 9 inches
- Wood Size 2 x 10 = Maximum Span of 13 feet, 8 inches
- Wood Size 2 x 12 = Maximum Span of 15 feet, 5 inches
Joist and beam spans are based on SPF Number 1 and 2 Grade. These tables are for reference only and spans will be checked to ensure they conform to the latest version of the Ontario Building Code. |
Permitted Overhangs |
- 2 x 6 Joists: None
- 2 x 8 Joists: 16” Maximum
- 2 x 10 Joists: 24” Maximum
- 2 x 12 Joists: 24” Maximum
- Beams: 12” Maximum
|
2-Ply Beams |
If the Support Length (SL) is 8 feet, the requirements are:
- 2-Ply Beam of 2 x 6 = 6’7”
- 2-Ply Beam of 2 x 8 = 8’5”
- 2-Ply Beam of 2 x 10 = 10’3”
- 2-Ply Beam of 2 x 12 = 11’11”
If the Support Length (SL) is 10 feet, the requirements are:
- 2-Ply Beam of 2 x 6 = 6’1”
- 2-Ply Beam of 2 x 8 = 7’6”
- 2-Ply Beam of 2 x 10 = 9’2”
- 2-Ply Beam of 2 x 12 = 10’8”
If the Support Length (SL) is 12 feet, the requirements are:
- 2-Ply Beam of 2 x 6 = 5’8”
- 2-Ply Beam of 2 x 8 = 6’10”
- 2-Ply Beam of 2 x 10 = 8’4”
- 2-Ply Beam of 2 x 12 = 9’9”
|
3-Ply Beams |
If the Support Length (SL) is 8 feet, the requirements are:
- 3-Ply Beam of 3 x 8 = 9’1”
- 3-Ply Beam of 3 x 10 = 11’8”
- 3-Ply Beam of 3 x 12 = 13’10”
If the Support Length (SL) is 10 feet, the requirements are:
- 3-Ply Beam of 3 x 8 = 8’5”
- 3-Ply Beam of 3 x 10 = 10’8”
- 3-Ply Beam of 3 x 12 = 12’4”
If the Support Length (SL) is 12 feet, the requirements are:
- 3-Ply Beam of 3 x 8 = 7’11”
- 3-Ply Beam of 3 x 10 = 9’9”
- 3-Ply Beam of 3 x 12 = 11’3”
|
Stairs and Handrail Design |
Guards to conform to SB-7 of OBC. The Ontario Building Code states that stairs must have uniform risers and runs.
- Minimum Rise of 4 7/8"
- Maximum Rise of 7 7/8"
- Minimum Run of 10"
- Maximum Run of 14"
|
Application Process
-
Email or call the Building Department.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall.
- Wait. The review process will take 3 to 6 weeks depending on the project and on the current workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, construction can begin according to revised plans.
- Call to book your inspections. Your project must be inspected at different stages. These are explained on your building permit.
Permit Fees Fees are subject to change. Building permit fees for a deck are $170 for 300 square feet plus $0.45/square feet after the first 300 square feet. A refundable fee is based on the value of construction:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $50,000 = $500 refundable fee
Inspections
Inspections for a deck
Inspection |
When the Inspection is Required |
Footing Inspection |
Before you pour the footings. You may require a copy of a soil test from an engineer before this inspection depending on your design or a copy of the engineer approval for any techno metal posts or equivalent, you can email your report to the Building Department. |
Framing Inspection |
This is before you cover the framing with decking or surround the deck with any enclosure. All beams and joists must be exposed and visible for the inspector. You may not have your stairs installed at this point, that is ok. |
Final Inspection |
When the entire project is complete, and your building permit file can be closed. All stairs, railings and guards must be installed for the final inspection. |
|
Demolitions |
You need to obtain a building permit to relocate or demolish an existing building or structure. Your demolition application will be reviewed to ensure compliance with applicable law, including the Ontario Heritage Act and the Zoning By-Law. The demolition of certain building types (silos, and barns) and non-load bearing interior partitions do not require a demolition permit.
Document Checklist
- Completed and signed Building Permit Application Form;
- Site plan indicating the location of the building being demolished;
- Engineer approval if the permit is to remove a structural supporting wall.
Application Process
- Email or call the Building or Zoning Departments.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, you have verified with any and all possible services implicated by the demolition, the demolition can begin.
6. Call to book your inspections. Your project may require a pre-demolition permit and a final inspection once the building has been removed.
Permit Fees Fees are subject to change. Building permit fees for the demolition of a residential building is $160. Building permit fees for the demolition of a non residential building is $315. A refundable fee is based on the value of the project:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $99,999 = $500 refundable fee
Inspections
Inspections for a demolition
Inspection |
When the Inspection is Required |
Final Inspection |
When all demolition work is completed, and your demolition permit file can be closed. |
|
Fence |
You do not require a permit to build a fence on your property. Visit our Fences page for general rules to follow when installing a fence. |
Finishing Your Basement or Renovating |
If you are planning on finishing your basement you may require a building permit. No permit is required to install drywall to finish a recreation room or space other than for a bedroom. If a bathroom is being added or completed (even if the underground plumbing was already installed and inspected at the time of original construction) a building permit is required. A building permit is required to add a bedroom to your basement.
Document Checklist
- Completed and signed Building Permit Application Form;
- One sets of construction plans and specifications including room sizes, room uses and window and door sizes. Window “glazed” area must also be included on the plan;
- A septic permit from South Nation Conservation for a private sewage system (if applicable).
Application Process
- Email or call the Building Department.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall. If any plumbing is being added to the building and you are serviced by a private septic system approval from South Nation Conservation is also required.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, construction can begin according to revised plans.
- Call to book your inspections. Your project must be inspected at different stages. These are explained on your building permit.
Permit Fees Fees are subject to change. Building permit fees to renovate or finish your basement are $170 for 300 square feet plus $0.45/square foot after the first 300 square feet. A plumbing permit will cost $110 for ten fixtures (a fixture is a toilet, a sink or a tub, and so on.) A refundable fee is based on the value of the project:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $99,999 = $500 refundable fee
- Construction value between $100,000 - $299,999 = $1000 refundable fee
Inspections
Inspections for finishing a basement or renovating
Inspection |
When the Inspection is Required |
Underground Plumbing Inspection |
Before covering the underground plumbing (if applicable). If the underground plumbing was already completed (with a permit) this inspection is not required. |
Framing Inspection |
Before insulation, you must have your plumbing, electrical, HVAC completed before this inspection. All Electrical work must be done through a permit from the Electrical Safety Authority. |
Above Ground Plumbing Inspection |
Before insulation, an air or water test must be on for this inspection (if applicable). |
Insulation Inspection |
Before drywalling, insulation and vapour barrier must be installed. |
Final Inspection |
When all construction work is completed, and your building permit file can be closed. |
|
Garage or Accessory Building |
Construction of an accessory building (detached garages and garden sheds), including prefabricated buildings, occupying an area greater than 15 square meters (161 square feet) requires a building permit. Prefabricated garages and sheds do require the same documents listed below. Ensure that the company you are purchasing the building from can provide detailed construction plans before you purchase the building.
Document Checklist
- Completed and signed Building Permit Application Form;
- One complete set of construction plans and specifications. If any plumbing is being added to the building and you are serviced by a private septic system approval from South Nation Conservation is also required.
- Layout from truss manufacturer for roof trusses;
- A detailed site plan;
- South Nation Conservation Authority Approval if proposed construction occurs near a water course
- A septic permit from South Nation Conservation for a private sewage system (if applicable).
Application Process
- Email or call the Building or Zoning Departments.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, construction can begin according to revised plans.
- Call to book your inspections. Your project must be inspected at different stages. These are explained on your building permit.
Permit Fees Fees are subject to change. Building permit fees for a garage or accessory building are $170 for 300 square feet plus $0.50/square foot after the first 300 square feet. A refundable fee is based on the value of construction:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $99,999 = $500 refundable fee
- Construction value between $100,000 - $299,999 = $1000 refundable fee
Inspections
Inspections for garage or accessory building
Inspection |
When the Inspection is Required |
Service Inspection |
Before covering the municipal service connections (if applicable). |
Footing Inspection |
Before you pour the footings or the slab on grade. You may be required to provide a copy of a soil test from an engineer before this inspection, you can email your report to the Building Department. A footing inspection is what would be required before pouring any concrete for a slab on grade as well. |
Underground Plumbing Inspection |
Before covering the underground plumbing (if applicable). |
Backfill Inspection |
Before backfilling the foundation (if applicable). |
Framing Inspection |
Before insulation, you must have your plumbing, electrical, HVAC completed before this inspection. All Electrical work must be done through a permit from the Electrical Safety Authority. |
Above Ground Plumbing Inspection |
Before insulation, an air or water test must be on for this inspection (if applicable). |
Insulation Inspection |
Before drywalling, insulation and vapour barrier must be installed. |
Final Inspection |
When all interior and exterior work is complete, and your building permit file can be closed. |
|
New Home |
Document Checklist
- Completed and signed Building Permit Application Form;
- Schedule 1: Designer information form prepared by the designer;
- One set of construction plans and specifications;
- A copy of a detailed site plan or Survey;
- Energy Efficiency Design Summary (EEDS), completed by the Designer;
- Copy of the Deed of Land establishing title of the property;
- TARION new home warranty program enrolment number (where required);
- Completed Mechanical Ventilation Summary sheet;
- Civic address application form, if not part of a subdivision;
- Septic permit from South Nation Conservation for a private sewage system;
- Approved water and sewer allocation if construction is serviced by Public Utilities;
- Detailed grading plan for properties of less than one acre in area. May also be required at the discretion of the Chief Building;
- South Nation Conservation Authority Approval if proposed construction occurs near a water course;
- Entrance permit (culvert) from Public Works department (or the United Counties of Prescott and Russell when bordering a county road).
Only complete applications will be accepted, and we may ask for more information once we start reviewing your application. Application Process
- Email or call the Building or Zoning Departments.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, construction can begin according to revised plans.
- Call to book your inspections. Your project must be inspected at different stages. These are explained on your building permit.
Permit Fees Fees are subject to change. Building Permit fees for a New Single Family Home are $1,800 for 3,000 square feet plus $0.70 per square feet after the first 3,000 square feet. If you are building a multi unit dwelling such as a semi detached or townhouse, the cost is $1,600 per unit. There are also fees for the following:
- Plumbing - $110 for 10 fixtures plus $11 per additional fixture
- Attached garage – $170 for 300 square feet plus $0.50/square foot after the first 300 square feet.
- Deck – $170 for 300 square feet plus $0.45/square foot after the first 300 square feet.
- Civic address post (if applicable) – $130
- Municipal water connection fees – $175
- Municipal sewer connection fees – $65
- Water meter (5/8”) – $307.65
A refundable fee is based on the value of the project:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $99,999 = $500 refundable fee
- Construction value between $100,000 - $299,999 = $1000 refundable fee
- Construction value between $300,000 - $599,999 = $2000 refundable fee
- Construction value greater than $600,000 = $5000 refundable fee
A refundable fee will be returned in full to the permit holder if the file is closed within one year of permit issuance date. For each year that passes after the first year the refundable fee will be reduced by 25% except for $5000 refundable fees, those refundable fees have two years before the 25% reduction in fees occurs. Additional fees that will typically apply for a new home are development charges , which vary depending on the location of the property. Inspections
Inspections for a New Single Family Home
Inspection |
When the Inspection is Required |
Service Inspection |
Before covering the municipal service connections. |
Footing Inspection |
Before you pour the footings. You must provide a copy of the soil test from your engineer before this inspection, you can email your report to the Building Department. |
Underground Plumbing Inspection |
Before covering the underground plumbing. |
Backfill Inspection |
Before backfilling the foundation. |
Framing inspection A |
Point load and truss inspection. |
Framing inspection B |
Before insulation, you must have your plumbing, electrical, HVAC completed before this inspection. All Electrical work must be done through a permit from the Electrical Safety Authority. |
Above Ground Plumbing Inspection |
Before insulation, an air or water test must be on for this inspection. |
Insulation Inspection |
Before drywalling, insulation and vapour barrier must be installed. |
Fire Resistance Rating |
Only applies in some cases and will be noted on your permit. |
Occupancy Inspection |
Before anyone occupies (lives in) the dwelling. |
Final Inspection |
When all interior and exterior work is complete, and your building permit file can be closed. |
|
Pool, Spa, or Hot Tub |
A Swimming Pool Permit is required before you install a pool, spa, or hot tub on your property. See our Pool and Spa Permits page for the application process and requirements. |
Secondary Dwelling Units (Adding an Apartment) |
Adding a single, self-contained rental apartment to your home provides your family with an additional source of income and provides your community (or a member of your family) with another source of affordable housing. Even an “in-law suite” for your family members would require a building permit to ensure Ontario Building Code compliance. Document Checklist
Only complete applications will be accepted, and we may ask for more information once we start reviewing your application. Application Process
- Email or call the Building or Zoning Departments.
- Submit your Building Permit Application and other required documents by email or in person at Town Hall.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive the results of your permit review. If your project is within building and zoning regulations, you will receive a permit. If your application is denied, you can make the needed changes to your application and resubmit.
- Receive your permit. Once the fees are paid, construction can begin according to revised plans.
- Call to book your inspections. Your project must be inspected at different stages. These are explained on your building permit.
Permit Fees Fees are subject to change. Building Permit fees for an additional dwelling unit being added to an existing dwelling are $1,600 flat fee per unit. A refundable fee is based on the value of the project:
- Construction value between 0-$24,999 = $100 refundable fee
- Construction value between $25,000 - $99,999 = $500 refundable fee
- Construction value between $100,000 - $299,999 = $1000 refundable fee
- Construction value between $300,000 - $599,999 = $2000 refundable fee
- Construction value greater than $600,000 = $5000 refundable fee
A refundable fee will be returned in full to the permit holder if the file is closed within one year of permit issuance date. For each year that passes after the first year the refundable fee will be reduced by 25% except for $5000 refundable fees, those refundable fees have two years before the 25% reduction in fees occurs. Development charges do not apply to an accessory dwelling unit (an apartment) that is being added to a home that is older than 5 years old. Additional fees that will typically apply for a new home are development charges , which vary depending on the location of the property. Inspections
Inspections for a Secondary Dwelling Unit
Inspection |
When the Inspection is Required |
Underground Plumbing Inspection |
Before covering the underground plumbing. |
Framing Inspection |
Before insulation, you must have your plumbing, electrical, HVAC completed before this inspection. All Electrical work must be done through a permit from the Electrical Safety Authority. |
Above Ground Plumbing Inspection |
Before insulation, an air or water test must be on for this inspection. |
Insulation Inspection |
Before drywalling, insulation and vapour barrier must be installed. |
Fire Resistance Rating |
When your fire separation components are visible to the inspector, this may require multiple inspections |
Occupancy Inspection |
Before anyone occupies (lives in) the new dwelling |
Final Inspection |
When all interior and exterior work is complete, and your building permit file can be closed. |
|
Septic System |
Property owners are responsible for all installation, maintenance, and repairs of the private well and septic tank on their land. Please refer to our Septic Tanks and Private Wells page for more information. |
Woodburning Appliances and Wood Stoves |
A building permit is required for the installation of a:
- Masonry fireplace /masonry chimney
- Woodstove and chimney
- Pellet stove (wood, corn, grain, etc.)
- Fireplace insert /chimney liner
- Pre-manufactured fireplace and chimney
Document Checklist
- Completed and signed Building Permit Application Form;
- Manufacture's specifications of the proposed unit;
- Sketch of where in the building the appliance will be installed.
Application Process
- Email or call the Building Department.
- Submit your Building Permit Application, a layout of the space showing the location of the new appliance and the manufacture’s specifications on the product you would like to install by email or in person at Town Hall.
- Wait. The review process will take a few weeks depending on the project and on the workload.
- Receive your permit. Once the fees are paid, installation can begin according to submitted plan and specifications.
- Have your new wood burning appliance inspected by someone who is WETT Certified and ensure you receive a letter of compliance. Provide a copy of this letter to the building department by email to the Building Department or in person at Town Hall. Once the compliance letter is provided your file will be closed and the $100 refundable fee will be returned to you.
Permit Fees Fees are subject to change. There is no cost for a building permit for woodburning appliances and wood stoves. There is a $100 refundable fee that is charged for each permit. A letter from a WETT Certified installer, certifying that the install meets all requirements will be required to close your file and get your $100 refund if the file is closed within one year of permit issuance. Inspections There are no inspections required by the Township of Russell, however, an inspection by a WETT Certified person is required. It is the permit holder’s responsibility to obtain the required compliance report. |
